Before a restroom trailer shows up on your jobsite, seven things need to be settled: a firm, level, drainable pad; a route the delivery truck can use on day one; a route the pump truck can still use in month three; the right number of standard 20A/120V circuits or a correctly sized generator; a potable water plan; a placement your safety manager has already signed off on; and the paperwork that lets our technician through the gate, meaning badging, site orientation, and a COI on file. Get those done and delivery day is a tow, a set, a hookup, and a walkthrough. Miss one and it becomes a lost day, usually with an electrician or a loader on the clock.
Most superintendents could list five of these from memory. The two that get missed are the second access question and the paperwork runway, because neither shows up as a problem until it is too late to fix cheaply.
The readiness list at a glance
Every item below has an owner on your side, and several have lead times that start before the truck is scheduled. Forward the rows: paperwork to the PM, circuits to the electrician, placement to safety. A row with no owner two weeks out is the row that will slip.
| Item | Usually owned by | Settle it by | What goes wrong if it slips |
|---|---|---|---|
| COI with site-specific verbiage, prequal profile | PM / procurement | About two weeks before delivery | Truck is ready, gate will not open |
| Technician badging, orientation, background check | Site safety / security | About two weeks before delivery | Unit delivered, nobody cleared to service it |
| Pad location and ground condition | Superintendent | Site walk, then re-check the day before | Trailer cannot be leveled, or sinks after rain |
| Delivery route and turnaround | Superintendent | Site walk | Unit dropped short of the pad |
| Pump truck route for the life of the job | Superintendent / logistics | Site walk, checked against the phasing plan | Unit unserviceable once the laydown yard fills |
| Circuits or generator, correct connection type | Electrician / superintendent | Before the delivery date is locked | Unplanned electrician call, no lights or heat |
| Potable water source or water box | Superintendent | Before the delivery date is locked | Trailer set but dry on day one |
| Placement sign-off | Safety manager | Before delivery day | Placement vetoed with the truck idling |
Ground: firm, level, and somewhere water leaves
Soft ground after rain is the single most common day-of problem we see. A trailer is leveled and blocked at the pad, and the blocking only works if what is underneath it stays put. A spot that looked fine on a dry site walk can be a rut by the time the truck backs in.

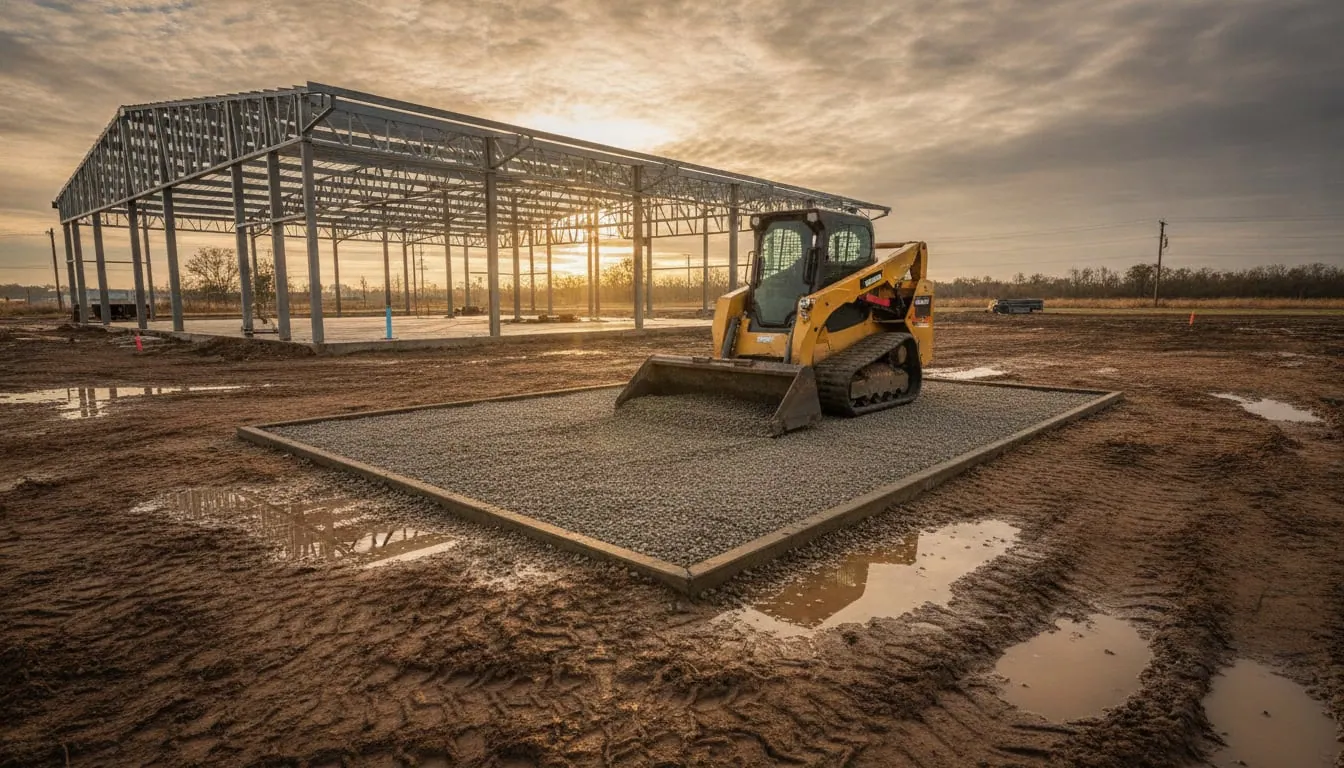

The fix is ordinary site work. A compacted gravel pad, even a modest one, beats native soil almost every time. Keep it out of low spots and out of the building's drainage path. It does not need to be perfectly flat, since we level with blocks, but it has to stay firm through freeze and thaw.
Plan for mud season specifically. A spring mobilization should assume the pad and the approach route are both at their worst on delivery day. A trailer that settles out of level later drains badly and its doors start binding.
The two access questions, and why only one gets asked
There are two separate access questions on every job, and buyers routinely think about only the first. Can the delivery truck reach the pad and get back out on day one? And can the pump truck reach the same pad every service visit in month three? The site on delivery day and the site three months later are different sites.

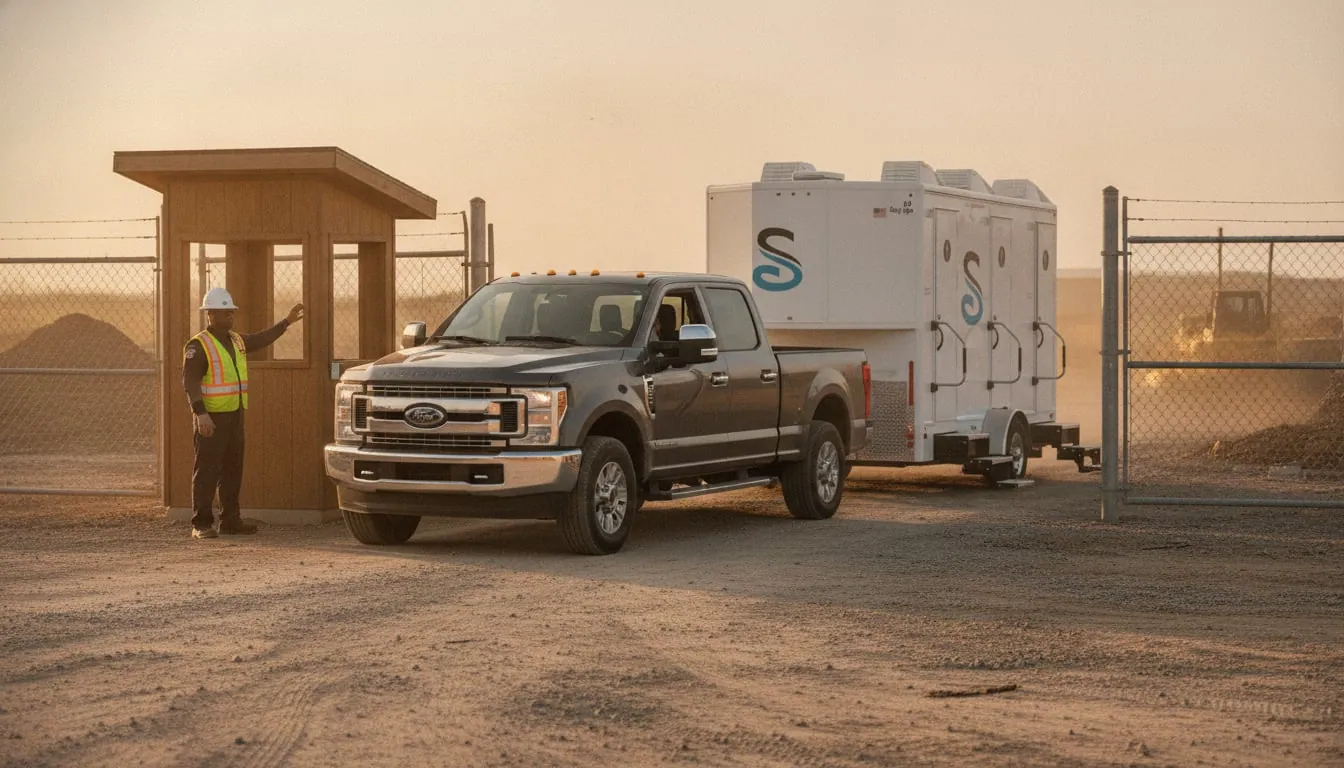

Day one: delivery and turnaround
A truck and trailer together are longer than most site traffic. Walk the route from the gate to the pad and look for the tight corner, the overhead line, the grade change, and where the rig turns around. On genuinely tight placements, units can be hand-positioned with a dolly rather than backed in, but that is a plan made ahead, not an improvisation.

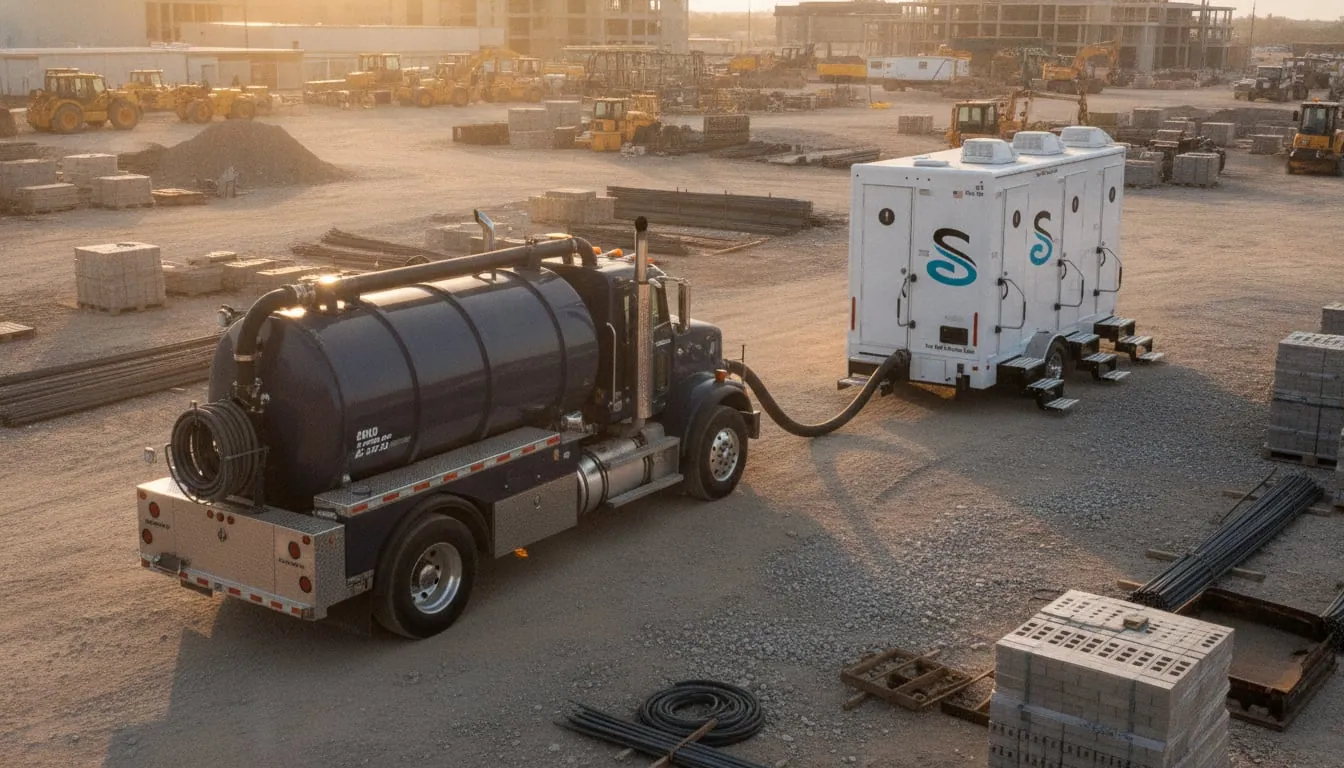

Month three: the pump truck
The service question is where most placement mistakes live. A spot that is wide open on day one gets boxed in as the job ramps: the laydown yard fills with steel and pipe, and a trade parks connex boxes along the only lane. Units get placed in spots that are perfect on day one and unreachable by a pump truck in month three. Look at the phasing plan, not the current aerial, and ask where materials will be staged at trade peak. The pump truck needs to park close to the waste connection every visit, in every weather. Our post on building a construction site logistics plan covers how to hold that lane open as the site fills.
Power: count circuits, not amps

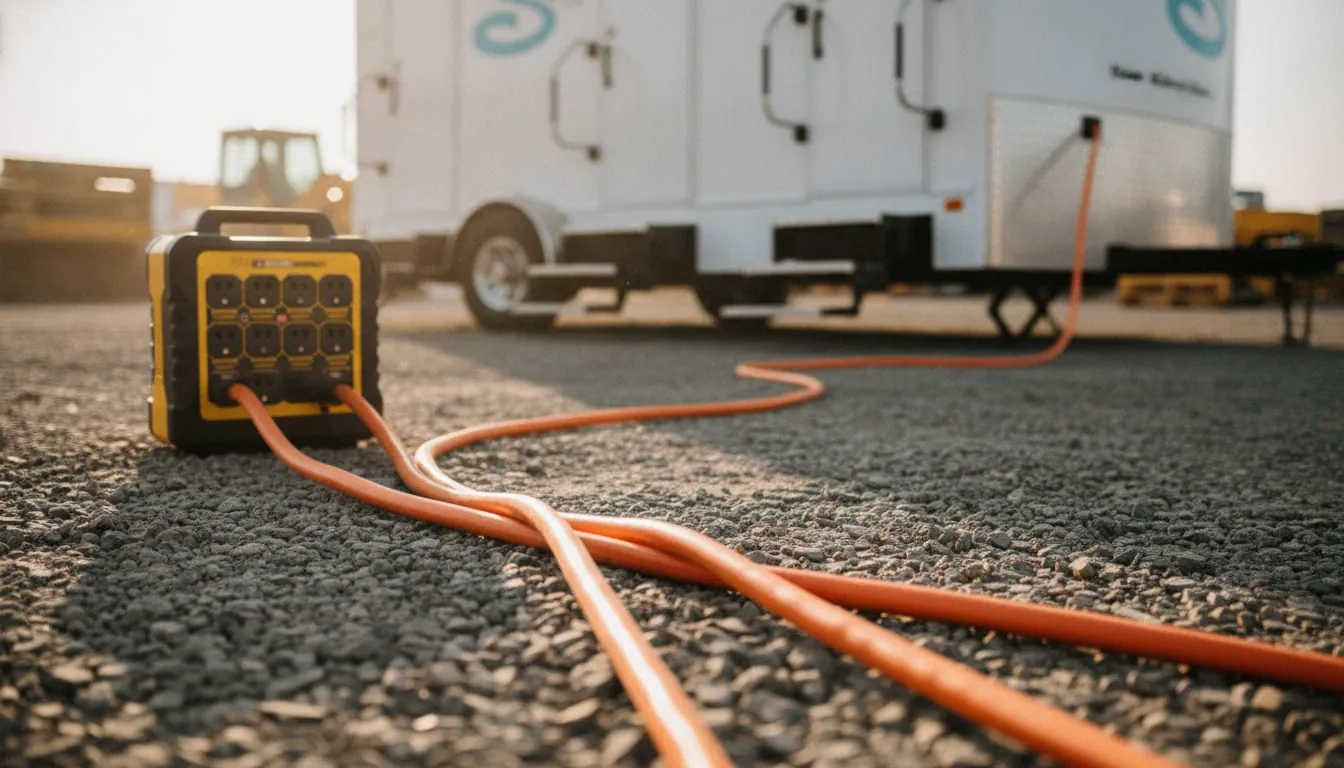

Our restroom and shower trailers run on multiple standard 20A/120V cords, one circuit per cord. What you need to know is how many circuits the unit wants, summer and winter, because the cold-weather systems add draw. Have that many dedicated circuits live at the pad before delivery day, or a generator sized to the actual load.
Confirm the connection type ahead of time. A mismatched receptacle or a bare-wire temporary panel means an unplanned electrician and a lost day. Temporary power on a construction site also has to meet OSHA 1926.404(b)(1), which requires GFCI protection or an assured equipment grounding conductor program for 120V, 15 and 20A receptacles that are not part of the permanent wiring.
Here is what each unit needs, with onboard water and waste for the water plan in the next section:
| Model | 20A circuits (summer / winter) | Fresh water | Waste holding | Layout |
|---|---|---|---|---|
| 2 Stall | 1 / 2 | 125 gal | 250 gal | Individual door |
| 4 Stall 4 Door | 1 / 3 | 200 gal | 440 gal | Individual door |
| 8 Stall 8 Door | 3 / 5 | 300 gal | 970 gal | Individual door |
| 10 Stall 7 Door | 3 / 5 | 400 gal (two 200 gal) | 970 gal | Individual door |
| 8 Stall 2 Door | 3 / 4 | 200 gal | 750 gal | Communal |
| 10 Stall 2 Door | 2 / 4 | 200 gal | 1,000 gal | Communal |
| 3 Stall ADA | 2 / 4 | 105 gal | 300 gal | ADA |
| 1 Stall ADA Restroom + Shower Combo | 2 / 3 | 105 gal | 140 gal | ADA |
| 8 Station 8 Door Shower | 3 / 4 | 300 gal | 970 gal | Individual door |
| 8 Station 2 Door Shower | 3 / 4 | 200 gal | 970 gal | Communal |
If the job runs into winter, plan the winter count from the start. Winter numbers support heat and the freeze-protection chain, which on our units is the HeatLock system, and the rule that goes with it is simple: the power stays on overnight, every night.
If there is no shore power at the pad, a generator carries the load. Size it to the circuits above, not to the biggest set in the yard. A diesel generator running below roughly 30 to 35 percent of its rated load wet-stacks, and an oversized set on a light restroom load is how that happens. Decide in writing who fuels it and on what schedule. Our guide to pull-behind generators for restroom and shower trailers walks through the sizing.
Water: a hookup, a water box, or a fill schedule
"There's a hydrant somewhere" is not a water plan. The trailer needs potable water, and there are three honest ways to supply it. A continuous connection to a potable source at or near the pad is the simplest, and it means the onboard fresh tank rarely matters. A water box on the pad supplies bulk fresh water where there is no tap, and a waste box does the same job on the holding side. Or the unit runs on its onboard tank, with fills on every service visit.
The table above tells you which of those you can live with. An 8 Stall 8 Door carries 300 gallons of fresh against 970 of waste, so the fresh side runs out about three times before the waste side is full. On a high-headcount pad without a hookup, that makes fresh water, not pump-out, the thing that sets your service interval. Shower units push that further; the 8 Station 2 Door Shower carries 200 fresh against 970 waste, about five fills per pump-out.
If you are connecting to a source, confirm it is potable, live, and how far it is from the pad. In cold months the outdoor supply line is the most freeze-prone part of the setup; our write-up on winter-proofing restroom and shower trailers on a jobsite covers protecting it.
Placement: where the crew actually walks
Placement is negotiated between the superintendent, the safety manager, and our driver, and it changes on site more often than not. Keep it short by getting the safety manager's input before delivery day, because safety can stop a placement plan the day before.
What safety will look at:
- Walking distance from the work. OSHA 1926.51 expects toilet facilities within prompt reach of active work areas. On a large spread, that usually means more than one bank, not one big one at the office.
- Hand-wash adjacency. Restroom trailers have sinks inside. Any portable toilet banks at the work faces need hand-wash stations beside them.
- Separation from equipment paths. Keep units and the walking route to them out of haul roads, swing radii, and delivery lanes.
- Lighting and footing. Shift change happens in the dark for half the year. Steps and the approach need light and a surface that is not ice or mud.
- Survival through the next phase. A pad that has to move in six weeks costs a relocation move. Pick a spot that holds through trade peak if you can.
On data-center and federal campuses, check the unit too. Many require individual-door restroom trailers like the 8 Stall 8 Door and reject communal layouts outright, so confirm the site standard before the unit is loaded.
Paperwork: the item with the longest lead time
The equipment is rarely what holds up a mobilization. The paperwork is. Prequalification commonly needs a two-week runway ahead of the delivery date: a certificate of insurance with the site-specific verbiage your owner or GC requires, EMR and safety documentation, a W-9, and a profile on whichever platform the site runs, such as Avetta or ISNetworld.
The technician is the other half. Our service tech needs the same credentials as everyone else on site: the badge, the orientation, and any background check the site requires. Send us the onboarding packet with the purchase order, not with the delivery date. The Council Bluffs hyperscaler data center job is a good picture of what that onboarding looks like on a badge-controlled program.
Delivery day, step by step
If everything above is settled, delivery day is short and predictable. It is a tow, a placement confirmation, a level-and-block, the connections, a function check, and a walkthrough with whoever will call us when something goes wrong.
| Step | What happens | What we need from you |
|---|---|---|
| Gate | Driver checks in, badges or escorts in | Gate list updated, escort named if required |
| Route | Truck follows the walked route to the pad | Lane clear of materials and parked trucks |
| Placement | Final position agreed on the pad | Superintendent or safety on hand to confirm |
| Level and block | Trailer leveled on blocks, stabilized | Pad firm and drained |
| Connections | Power cords, water, waste as applicable | Circuits live and labeled, water source live |
| Function check | Water, flush, lights, HVAC or heat, heat trace in winter | Nothing, unless a circuit trips |
| Walkthrough | How the unit works, who to call, service schedule | The person who will own the unit day to day |
On a site that grows, the same checklist runs again for every step-change add, just faster, because the pad, route, and paperwork are already proven. That repetition is what makes a program like the Ellendale data center project work in North Dakota in January.
Frequently asked questions
Does a restroom trailer need a concrete pad?
No, a restroom trailer does not need concrete. It needs ground that is reasonably level, firm, and drains. A compacted gravel pad is the usual answer on a jobsite, and native soil can work in dry conditions, but soft ground after rain is the most common day-of problem.
How much power does a jobsite restroom trailer need?
It needs multiple standard 20A/120V circuits, not a single large service. An 8 Stall 8 Door needs three circuits in summer and five in winter; a 4 Stall 4 Door needs one and three. Plan the winter count if the job runs into cold months.
Can we run the trailer off a generator?
Yes, and on remote or shutdown work it is normal. Size the generator to the actual circuit load rather than the biggest unit available, because a diesel set running lightly loaded wet-stacks. Agree in writing on who fuels it and how often.
What if we have no water connection at the pad?
Then the trailer runs on a water box or on its onboard fresh tank with fills on every service visit. Either works. On high-headcount pads, fresh water rather than waste usually sets the service interval, so size the plan to that.
How far ahead do we need the COI and badging done?
Plan on about two weeks. Certificates with site-specific verbiage, prequal platform profiles, background checks, and orientation each run on their own clock, and first-time onboarding with a sanitation vendor almost always takes longer than expected.
What happens if the pump truck can't reach the trailer later?
Then the unit either goes unserviced or gets moved, and a relocation move is a small delivery with its own leveling, reconnection, and schedule reset. It is far cheaper to hold a service lane open in the logistics plan from day one.
Who needs to be on site when the trailer arrives?
Someone who can confirm the final placement and someone who will own the unit day to day, which is often the same person. Safety should have signed off on the spot beforehand, so the conversation on the pad is a confirmation, not a debate.
Before you lock the date
Run the first table past your PM, electrician, and safety manager until every row has an owner. Any line you cannot answer yet, like where the pump truck parks at trade peak, is worth talking through before the order rather than on the pad. Our construction page shows how we set up jobsite programs, and when you are ready to put numbers to your site, send the headcount, the phasing, and the pad details through the quote form and we will build the plan around them.
Need a Restroom Trailer?
Get a free, no-obligation quote. We'll help you find the perfect solution.
Get a Free QuoteRelated Posts
Adding Restroom Trailers Mid Project: When Headcount Doubles
Headcount doubled mid job. How fast restroom trailers can be added, what a step-change add changes, and why every add carries its own minimum term.
Restroom Trailer Frozen: What To Do Right Now On A Jobsite
A frozen restroom trailer at 6am: safe triage steps in order, what not to do, a symptom table, and what a technician actually does on a freeze call.
Commercial Construction Portable Restrooms: The Metro Site Program
How to phase restroom trailers, hand-wash and service on a 12-18 month metro commercial build, and what keeps the program steady in month eleven.
